Critical Path Analysis

From an AS paper

Edexcel

Edexcel · Old spec

A2 June 2025 Q6

EdexcelCurrent spec13 marksCritical Path Analysis

6.

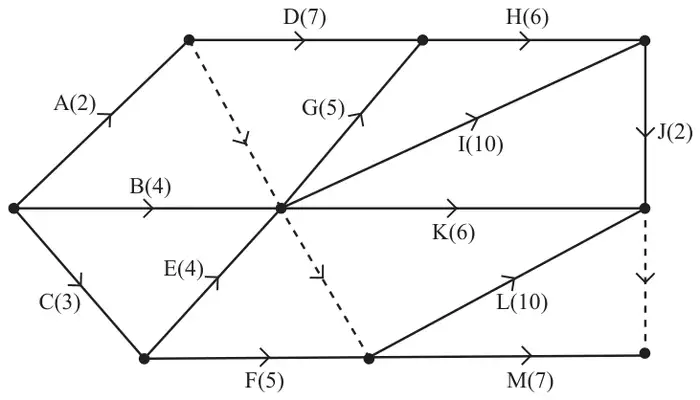

Figure 3: activity network with activities A(2), B(4), C(3), D(7), E(4), F(5), G(5), H(6), I(10), J(2), K(6), L(10), M(7) and three dummies
Figure 3

A project is modelled by the activity network shown in Figure 3. The activities are represented by the arcs. The number in brackets on each arc gives the time, in hours, to complete the corresponding activity. The project is to be completed in the shortest possible time.

(a) Complete Table 1 in the answer book to show the immediately preceding activities for each activity. (2)
ActivityImmediately preceding activitiesActivityImmediately preceding activities
AG
BH
CI
DJ
EK
FL
M

Table 1

(b) Complete Diagram 1 in the answer book to show the early event times and the late event times. (4)
Diagram 1: the network of Figure 3 with an empty box at each event for the early event time (top) and late event time (bottom)
Diagram 1
(c) Draw a Gantt chart for this project on Grid 1 in the answer book. (4)
Grid 1: blank grid with a time axis from 0 to 24
Grid 1
Figure 4: resource histogram, number of workers against time in hours: 4 from 0 to 2, 5 from 2 to 3, 8 from 3 to 4, 6 from 4 to 7, 8 from 7 to 8, 9 from 8 to 9, 7 from 9 to 12, 6 from 12 to 13, 5 from 13 to 15, 4 from 15 to 17, 2 from 17 to 20
Figure 4

The resource histogram in Figure 4 shows the number of workers required when each activity starts at its earliest possible time. When an activity is started it must be completed without interruption. Each activity requires at least one worker.

(d) By considering which activities are happening each hour, and by working backwards from the minimum project completion time, complete Table 2 in the answer book to show the number of workers needed for each activity. (3)
ActivityNumber of WorkersActivityNumber of Workers
AG
BH
CI
DJ
EK
FL
M

Table 2

AS June 2025 Q2

EdexcelAS paperCurrent spec8 marksCritical Path Analysis

2.

ActivityImmediately preceding activities
A-
B-
C-
DB
EA, B
FB
GB
HC, D
IG, H
JE
KE, F, I
LG, H
MG, H
(a) Explain how you can deduce from the precedence table that at least one dummy will be needed when drawing the activity network. Your explanation should refer to specific activities. (1)
(b) Draw the activity network described in the precedence table, using activity on arc. Your activity network must contain the minimum number of dummies only. (5)

Each activity in the precedence table takes 3 hours to complete.

(c) State the minimum completion time. (1)

One of the activities now needs to be chosen to be extended by an hour. When the change is made the minimum completion time must not be affected.

(d) List the activities that could be chosen. (1)

A2 June 2024 Q6

EdexcelCurrent spec11 marksCritical Path Analysis

6. The precedence table below shows the 12 activities required to complete a project.

ActivityImmediately preceding activities
A–
B–
C–
DA
EA, B, C
FA, B, C
GC
HD, E
ID, E
JD, E
KF, G, J
LF, G
(a) Draw the activity network described in the precedence table, using activity on arc.
Your activity network must contain the minimum number of dummies only. (5)

Each of the activities shown in the precedence table requires one worker. The project is to be completed in the minimum possible time.

Figure 3: schedule for three workers on a time axis from 0 to 20: worker 1 C 0-7, E 7-12, J 12-15, K 15-20; worker 2 A 0-4, D 4-8, G 8-12, H 12-14, I 14-18; worker 3 B 0-5, idle 5-7, F 7-9, idle 9-12, L 12-15
Figure 3

Figure 3 shows a schedule for the project using three workers.

(b)
(i) State the critical path for the network.
(ii) State the minimum completion time for the project.
(iii) Calculate the total float on activity B.
(iv) Calculate the total float on activity G. (4)

Immediately after the start of the project, it is found that the duration of activity I, as shown in Figure 3, is incorrect. In fact, activity I will take 8 hours.
The durations of all the other activities remain as shown in Figure 3.

(c) Determine whether the project can still be completed in the minimum completion time using only three workers when the duration of activity I is 8 hours.
Your answer must make specific reference to workers, times and activities. (2)

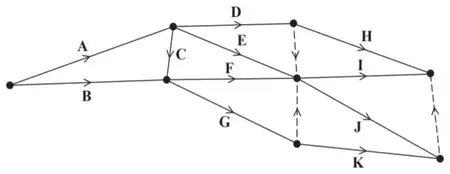

AS June 2024 Q2

EdexcelAS paperCurrent spec8 marksCritical Path Analysis

2. A company manages an awards evening.

The table below lists the activities required to set up the room for the evening, and their immediately preceding activities. Each activity requires exactly one person.

ActivityImmediately preceding activities
A-
BA
CA
DC
EC
FB, D, E
GE
HB
JH, F, G

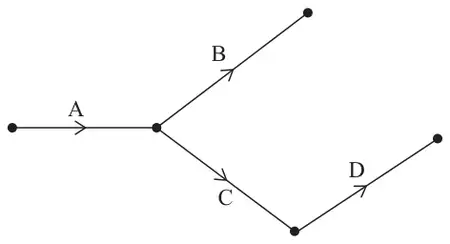

Figure 1 shows a partially completed activity network used to model the project. Each activity is represented by an arc.

Figure 1: partial activity network with A from the start node, B and C from the end of A, and D from the end of C
Figure 1
(a) Add the remaining five activities to Diagram 1 in the answer book to complete the activity network, using exactly two dummies. (3)

[Diagram 1 in the answer book is a copy of Figure 1.]

In addition to setting up the room, the company must prepare the meals for the guests. Figure 2 shows the activity network for preparing the main courses. The numbers in brackets represent the time, in minutes, to complete each task.

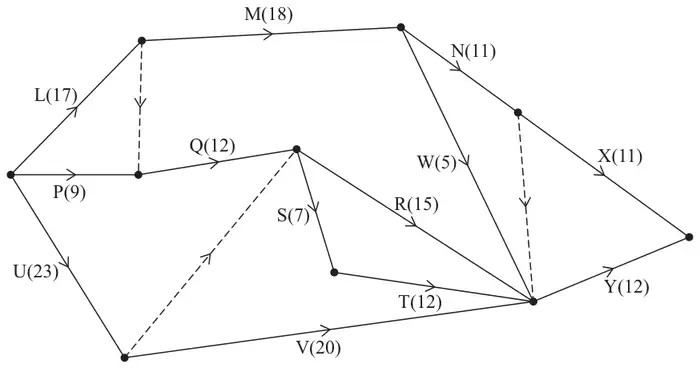

Figure 2: activity network with activities L(17), M(18), N(11), X(11), P(9), Q(12), S(7), R(15), T(12), W(5), U(23), V(20), Y(12) and three dummies

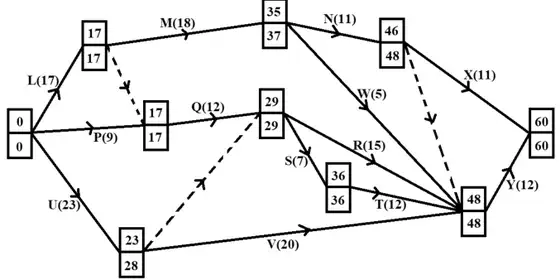

Figure 2

(b) Complete Diagram 2 in the answer book to show the early event times and the late event times for the activity network shown in Figure 2. (3)
Diagram 2: the network of Figure 2 with an empty box at each event for the early event time (top) and late event time (bottom)
Diagram 2
(c) State the critical activities. (1)
(d) Given that the main courses need to be ready to be served (with all activities completed) at 8 pm, state the latest time that activity R can start. (1)

A2 June 2023 Q6

EdexcelCurrent spec9 marksCritical Path Analysis

6. The precedence table below shows the twelve activities required to complete a project.

ActivityImmediately preceding activities
A–
B–
C–
DA
EA, B
FD, E
GA, B, C
HF, G
ID, E
JD, E
KF, G, I, J
LI
(a) Draw the activity network described in the precedence table, using activity on arc. Your activity network must contain the minimum number of dummies only. (5)

Figure 6: partially completed cascade chart on a time axis from 0 to 26: B 0-6, E 6-12, I 12-19, L 19-24 on the top row; A 0-5 with float to 6; C 0-7 with float to 15; D 5-9 with float to 12; G 7-10 with float to 18; H 16-22 with float to 24
Figure 6

Figure 6 shows a partially completed cascade chart for the project. The non-critical activities F, J and K are not shown in Figure 6.

The time taken to complete each activity is given in hours and the project is to be completed in the minimum possible time.

(b) State the critical activities. (1)

Given that the total float of activity F is 2 hours,

(c) state the duration of activity F. (1)

The duration of activity J is \(x\) hours, and the duration of activity K is \(y\) hours, where \(x \gt 0\) and \(y \gt 0\)

(d)
(i) State, in terms of \(y\), the maximum possible total float for activity K.
(ii) State, in terms of \(x\) and \(y\), the total float for activity J. (2)

A2 June 2023 Q2

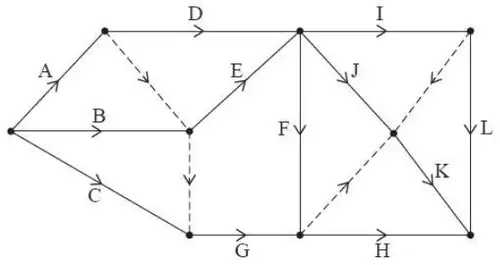

EdexcelCurrent spec7 marksCritical Path Analysis

2.

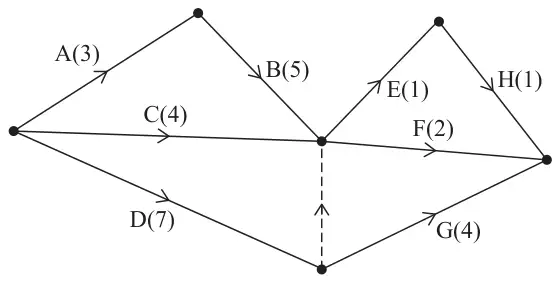

Figure 3: activity network: A(3) and C(4) and D(7) leave the start; B(5) follows A; C ends at the same event as B; a dummy runs from the end of D to the end of B and C; E(1) and F(2) leave that event; H(1) follows E; G(4) follows D; F, G and H end at the finish
Figure 3

The network in Figure 3 shows the activities that need to be undertaken to complete a project. Each activity is represented by an arc and the duration, in hours, of the corresponding activity is shown in brackets.

(a)
(i) Complete Diagram 1 in the answer book to show the early event times and the late event times.

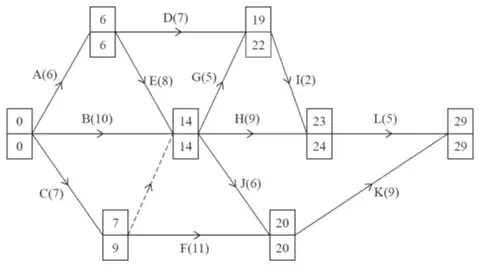

(ii) State the minimum completion time of the project. (3)

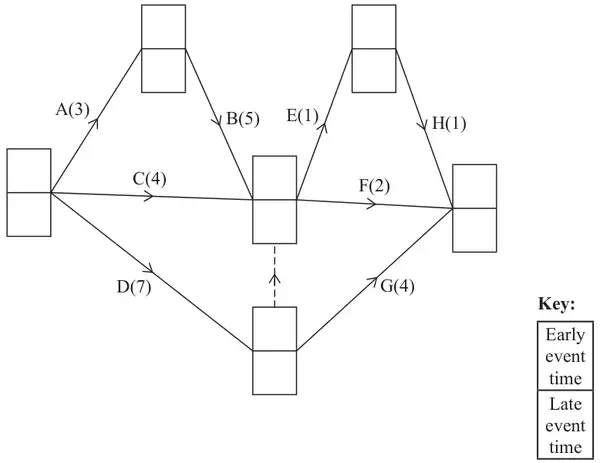

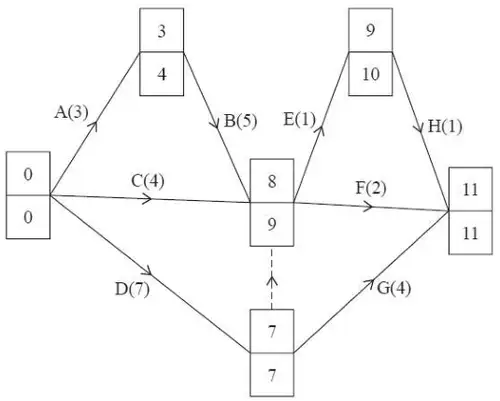

Diagram 1: the network of Figure 3 with an empty box at each event for the early event time (top) and late event time (bottom)

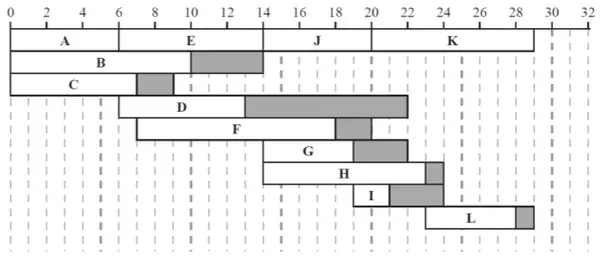

Diagram 1

The table below lists the number of workers required for each activity in the project.

ActivityNumber of workers
A2
B1
C2
D2
E3
F2
G1
H3

Each worker is able to do any of the activities. Once an activity is started it must be completed without interruption. It is given that each activity begins at its earliest possible start time.

(b)
(i) On Grid 1 in the answer book, draw a resource histogram to show the number of workers required at each time.
(ii) Hence state the time interval(s) when six workers are required. (4)
Grid 1: blank grid, number of workers from 0 to 8 against time in hours from 0 to 14

Grid 1

AS June 2023 Q2

EdexcelAS paperCurrent spec10 marksCritical Path Analysis

2.

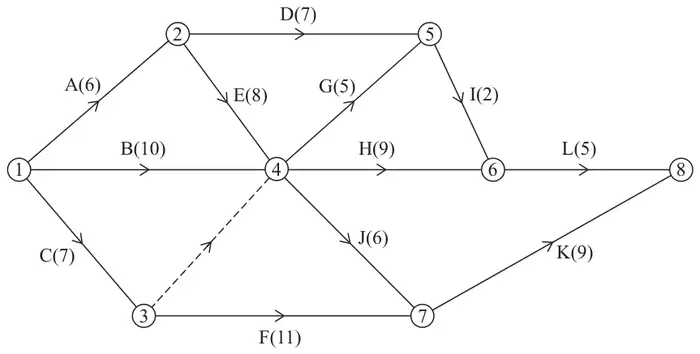

Figure 1: activity network with events 1 to 8: A(6) 1-2, B(10) 1-4, C(7) 1-3, D(7) 2-5, E(8) 2-4, dummy 3-4, F(11) 3-7, G(5) 4-5, H(9) 4-6, J(6) 4-7, I(2) 5-6, L(5) 6-8, K(9) 7-8
Figure 1

A project is modelled by the activity network shown in Figure 1. The activities are represented by the arcs. The number in brackets on each arc gives the time required, in hours, to complete the corresponding activity. The numbers in circles are the event numbers. Each activity requires one worker, and the project is to be completed in the shortest possible time.

(a) Explain the significance of the dummy activity from event 3 to event 4 (1)
(b) Complete Diagram 1 in the answer book to show the early event times and the late event times. (3)
Diagram 1: the network of Figure 1 with an empty box at each event for the early event time (top) and late event time (bottom)
Diagram 1
(c) State the critical activities. (1)
(d) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (1)
(e) Draw a Gantt chart for this project on Grid 1 in the answer book. (4)
Grid 1: blank grid with a time axis from 0 to 32
Grid 1

A2 June 2022 Q5

EdexcelCurrent spec14 marksCritical Path Analysis

5.

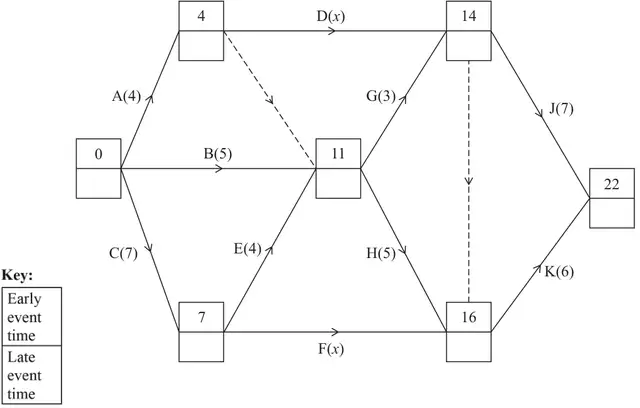

Figure 2: activity network with early event times: A(4), B(5) and C(7) leave the start (0); A ends at an event with early time 4, from which D(x) leaves and a dummy runs to the event at 11; C ends at an event with early time 7, from which E(4) and F(x) leave; B and E end at the event with early time 11, from which G(3) and H(5) leave; D and G end at the event with early time 14, from which J(7) leaves and a dummy runs to the event at 16; F and H end at the event with early time 16, from which K(6) leaves; J and K end at the finish (22); the late event time boxes are empty
Figure 2

The network in Figure 2 shows the activities that need to be completed for a project. Each activity is represented by an arc and the duration of the activity, in days, is shown in brackets. The early event times are shown in Figure 2.

(a) Complete Table 1 in the answer book to show the immediately preceding activities for each activity. (2)
ActivityImmediately preceding activityActivityImmediately preceding activity

A F
B G
C H
D J
E K

Table 1

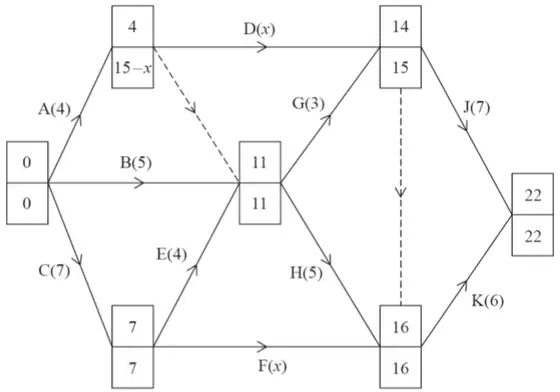

It is given that \(4 \lt x \leqslant m\)

(b) State the largest possible integer value of \(m\). (1)
(c)
(i) Complete Diagram 1 in the answer book to show the late event times.
(ii) State the activities that must be critical. (3)

[Diagram 1 in the answer book is a copy of Figure 2.]

(d) Calculate the total float for activity G. (1)

The resource histogram in Figure 3 shows the number of workers required when each activity starts at its earliest possible time. The histogram also shows which activities happen at each time.

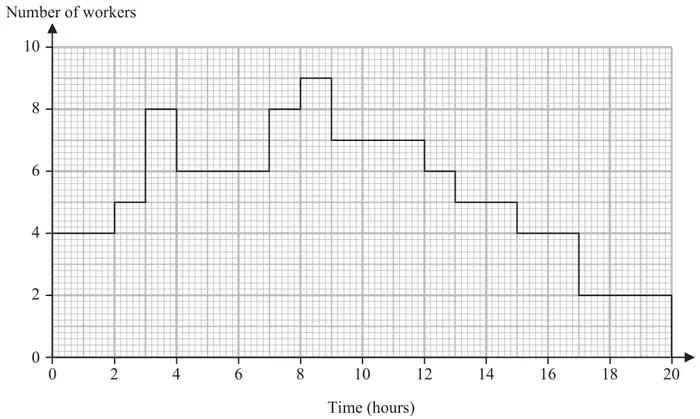

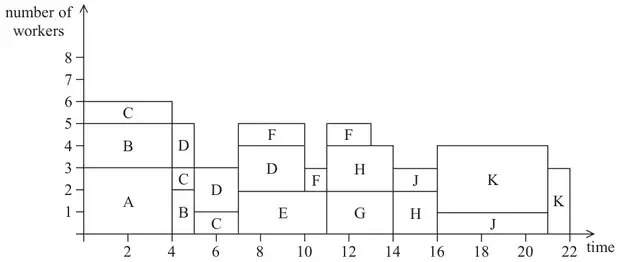

Figure 3: resource histogram, number of workers against time: 0 to 4, A (3 workers), B (2) and C (1), total 6; 4 to 5, B (2), C (1) and D (2), total 5; 5 to 7, C (1) and D (2), total 3; 7 to 10, E (2), D (2) and F (1), total 5; 10 to 11, E (2) and F (1), total 3; 11 to 13, G (2), H (2) and F (1), total 5; 13 to 14, G (2) and H (2), total 4; 14 to 16, H (2) and J (1), total 3; 16 to 21, J (1) and K (3), total 4; 21 to 22, K (3), total 3
Figure 3
(e) Complete Table 2 in the answer book to show the number of workers required for each activity of the project. (2)
ActivityNumber of workersActivityNumber of workers
A F
B G
C H
D J
E K

Table 2

(f) Draw a Gantt chart on Grid 1 in the answer book to represent the activity network. (5)
Grid 1: blank grid with time from 0 to 22
Grid 1

AS June 2022 Q2

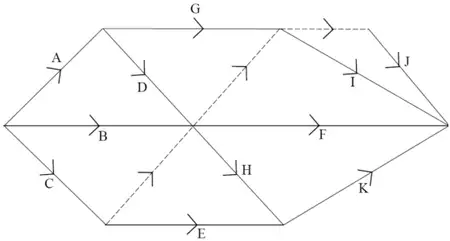

EdexcelAS paperCurrent spec8 marksCritical Path Analysis

2.

ActivityImmediately preceding activities
A–
B–
C–
D–
EA
FA, B, C
GC
HC
IE
JE, F, G
KD, H
(a) Draw the activity network described in the precedence table above, using activity on arc. Your activity network must contain the minimum number of dummies only. (5)
(b) Explain why it is necessary to draw a dummy from the end of activity A. (1)

Every activity shown in the precedence table has the same duration.

(c) State which activity cannot be critical, justifying your answer. (2)

A2 October 2021 Q7

EdexcelCurrent spec8 marksCritical Path Analysis

7.

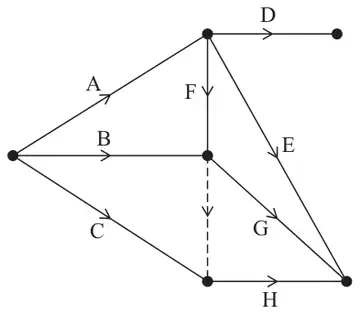

Figure 5: partial activity network: A, B and C leave the start; D, E and F leave the end of A; F ends at the end of B; a dummy runs from there to the end of C; G leaves the end of B and F; H leaves the end of C and the dummy; E, G and H end at the same event; D ends at its own event
Figure 5

Figure 5 shows a partially completed activity network for a project that consists of 14 activities.

(a) Complete the precedence table in the answer book for the 8 activities in Figure 5. (2)
ActivityImmediately preceding activitiesActivityImmediately preceding activities
A E
B F
C G
D H

The precedence table for the remaining 6 activities is given below.

ActivityImmediately preceding activities
ID, E, G, H
JD, E, G, H
KE, G, H
LI, J, K
MJ, K
NJ, K
(b) Complete the activity network in the answer book for the project. Your completed activity network must contain only the minimum number of dummies. (4)

[The activity network in the answer book is a copy of Figure 5.]

Given that all 14 activities have the same duration,

(c) explain why activity D cannot be critical. (2)

A2 October 2021 Q2

EdexcelCurrent spec9 marksCritical Path Analysis

2.

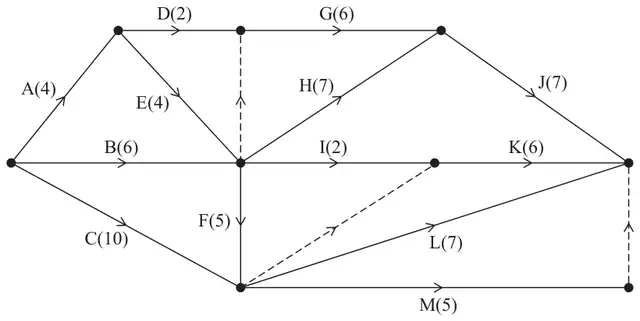

Figure 2: activity network: A(4), B(6) and C(10) leave the start; D(2) and E(4) follow A; B and E end at the same event, from which a dummy runs up to the end of D, and H(7), I(2) and F(5) leave; G(6) follows the end of D and the dummy; C and F end at the same event, from which a dummy runs to the end of I, and L(7) and M(5) leave; J(7) follows G and H; K(6) follows the end of I and the dummy; J, K and L end at the finish; a dummy runs from the end of M to the finish
Figure 2

A project is modelled by the activity network shown in Figure 2. The activities are represented by the arcs. The number in brackets on each arc gives the time, in hours, to complete the corresponding activity.

(a) Complete Diagram 1 in the answer book to show the early event times and the late event times. (4)
Diagram 1: the network of Figure 2 with an empty box at each event for the early event time (top) and late event time (bottom)
Diagram 1

Each activity requires one worker and the project must be completed in the shortest possible time using as few workers as possible.

(b) Calculate a lower bound for the number of workers needed to complete the project in the shortest possible time. You must show your working. (2)
(c) Schedule the activities using Grid 1 in the answer book. (3)

Grid 1: blank scheduling grid with time from 0 to 26
Grid 1

A2 October 2020 Q2

EdexcelCurrent spec15 marksCritical Path Analysis

2.

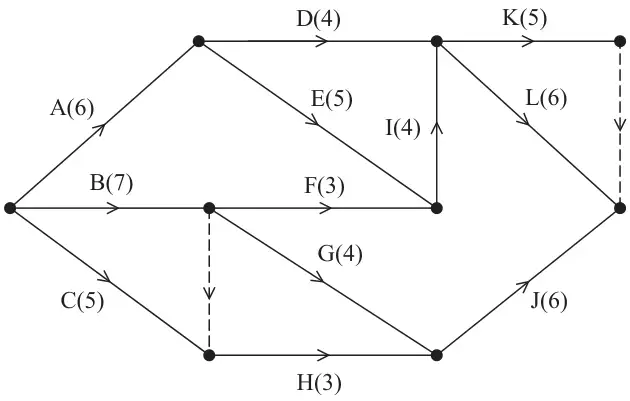

Figure 1: activity network: A(6), B(7) and C(5) leave the start; D(4) and E(5) follow A; F(3) and G(4) follow B; a dummy from the end of B to the end of C; H(3) follows that event; I(4) runs from the end of E and F up to the end of D; K(5) and L(6) follow; J(6) follows G and H; a dummy from the end of K to the finish; L and J end at the finish
Figure 1

The network in Figure 1 shows the activities that need to be undertaken to complete a project. Each activity is represented by an arc and the duration, in hours, of the corresponding activity is shown in brackets.

(a) Explain why each of the dummy activities is required. (2)
(b) Complete the table in the answer book to show the immediately preceding activities for each activity. (2)
ActivityImmediately preceding activities
A
B
C
D
E
F
G
H
I
J
K
L
(c)
(i) Complete Diagram 1 in the answer book to show the early event times and the late event times.
(ii) State the minimum completion time for the project.
(iii) State the critical activities. (6)

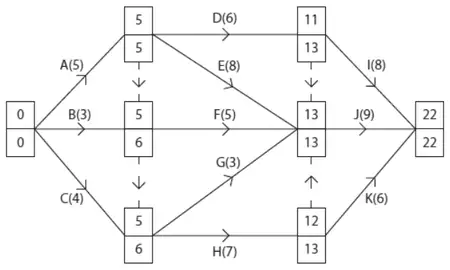

Diagram 1: the network of Figure 1 with an empty box at each event for the early event time (top) and late event time (bottom)
Diagram 1

Each activity requires one worker. Each worker is able to do any of the activities. Once an activity is started it must be completed without interruption.

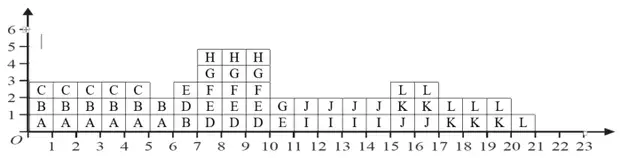

(d) On Grid 1 in the answer book, draw a resource histogram to show the number of workers required at each time when each activity begins at its earliest possible start time. (3)
Grid 1: blank grid, number of workers from 0 to 6 against time in hours from 0 to 23
Grid 1
(e) Determine whether or not the project can be completed in the minimum possible time using fewer workers than the number indicated by the resource histogram in (d). You must justify your answer with reference to the resource histogram and the completed Diagram 1. (2)

AS October 2020 Q2

EdexcelAS paperCurrent spec14 marksCritical Path Analysis

2.

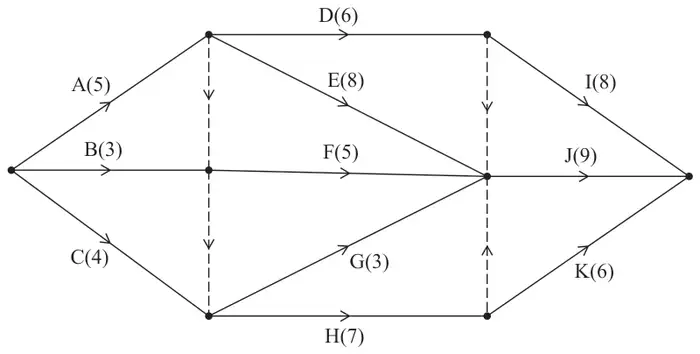

Figure 1: activity network with activities A(5), B(3), C(4) from the start, D(6), E(8), F(5), G(3), H(7), I(8), J(9), K(6), and four dummies
Figure 1

A project is modelled by the activity network shown in Figure 1. The activities are represented by the arcs. The number in brackets on each arc gives the time, in hours, to complete the corresponding activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete the precedence table in the answer book. (2)
ActivityImmediately preceding activities
A
B
C
D
E
F
G
H
I
J
K
(b) Complete Diagram 1 in the answer book to show the early event times and the late event times. (3)
Diagram 1: the network of Figure 1 with an empty box at each event for the early event time (top) and late event time (bottom)
Diagram 1
(c)
(i) State the minimum project completion time.
(ii) List the critical activities. (2)
(d) Calculate the maximum number of hours by which activity H could be delayed without affecting the shortest possible completion time of the project. You must make the numbers used in your calculation clear. (1)
(e) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)
(f) Draw a cascade chart for this project on Grid 1 in the answer book. (3)
Grid 1: blank grid with a time axis from 0 to 26
Grid 1
(g) Using the answer to (f), explain why it is not possible to complete the project in the shortest possible time using the number of workers found in (e). (1)

A2 June 2019 Q5

EdexcelCurrent spec6 marksCritical Path Analysis

5.

ActivityImmediately preceding activities
A–
B–
C–
DA
EC
FB, C, D
GA
HB, C, D
IB, C, D, G
JB, C, D, G
KE, H

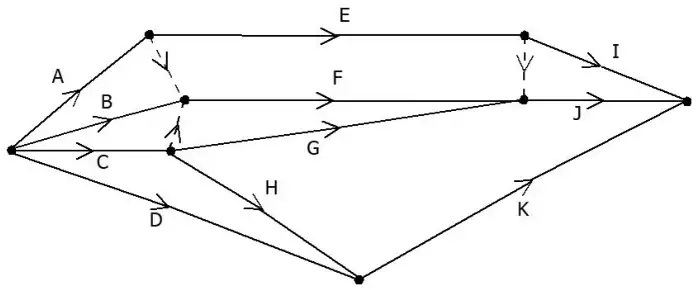

(a) Draw the activity network described in the precedence table above, using activity on arc. Your activity network must contain only the minimum number of dummies. (5)

Given that all the activities shown in the precedence table have the same duration,

(b) state the critical path for the network. (1)

A2 June 2019 Q4

EdexcelCurrent spec9 marksCritical Path Analysis

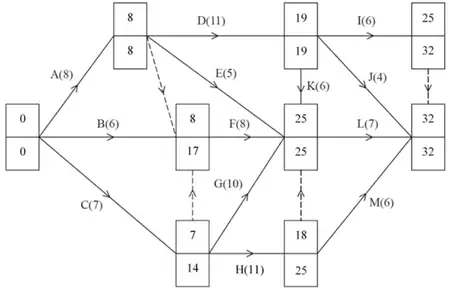

4.

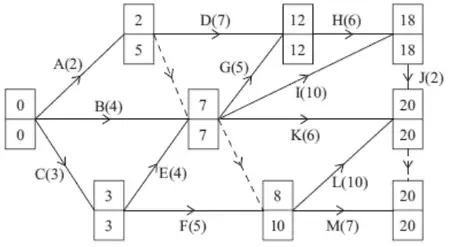

Figure 3: activity network with activities A(8), B(6), C(7), D(11), E(5), F(8), G(10), H(x), I(6), J(4), K(6), L(7), M(6) and four dummies, with an empty early/late event time box at each event; the late event time at the end of H is 25
Figure 3

The network in Figure 3 shows the activities that need to be undertaken to complete a project. Each activity is represented by an arc and the duration of the activity, in days, is shown in brackets. The early event times and late event times are to be shown at each vertex and one late event time has been completed for you.

The total float of activity H is 7 days.

(a) Explain, with detailed reasoning, why \(x = 11\) (2)
(b) Determine the missing early event times and late event times, and hence complete Diagram 1 in your answer book. (3)

[Diagram 1 in the answer book is a copy of Figure 3.]

Each activity requires one worker and the project must be completed in the shortest possible time using as few workers as possible.

(c) Calculate a lower bound for the number of workers needed to complete the project in the shortest possible time. (1)

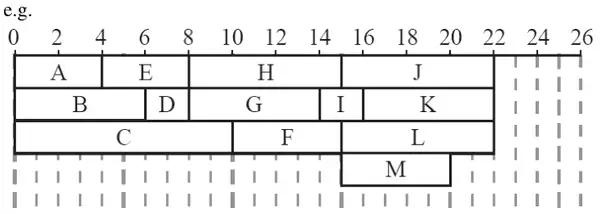

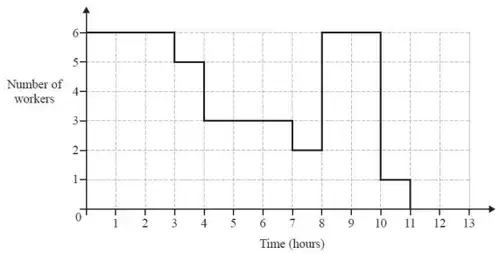

(d) Schedule the activities using Grid 1 in the answer book. (3)

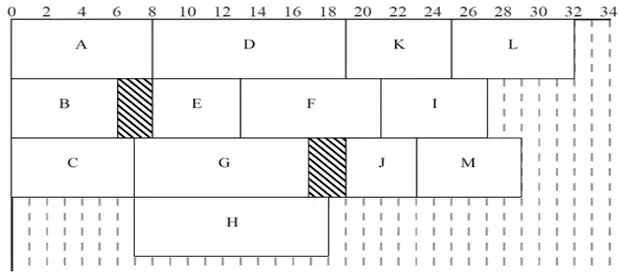

Grid 1: blank grid with a time axis from 0 to 34
Grid 1

AS June 2019 Q3

EdexcelAS paperCurrent spec7 marksCritical Path Analysis

3.

ActivityImmediately preceding activities
A-
B-
CA
DA
EA
FB, C
GB, C
HD
ID, E, F, G
JD, E, F, G
KG
(a) Draw the activity network described in the precedence table above, using activity on arc. Your activity network must contain the minimum number of dummies. (5)

Every activity shown in the precedence table has the same duration.

(b) Explain why activity B cannot be critical. (1)
(c) State which other activities are not critical. (1)

AS June 2018 Q3

EdexcelAS paperCurrent spec10 marksCritical Path Analysis

3.

ActivityTime taken (days)Immediately preceding activities
A5–
B8–
C4–
D14A
E10A
F3B, C, E
G7C
H5D, F, G
I7H
J9H

The table above shows the activities required for the completion of a building project. For each activity, the table shows the time it takes, in days, and the immediately preceding activities. Each activity requires one worker. The project is to be completed in the shortest possible time.

Figure 2: partially completed activity network with A(5), B(8) and C(4) from the start, and F(3), H(5) and I(7) in a chain after B

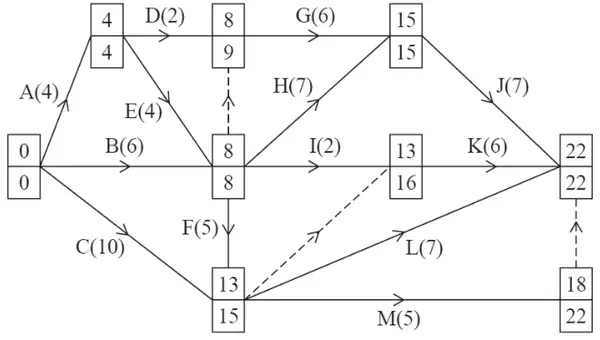

Figure 2

Figure 2 shows a partially completed activity network used to model the project. The activities are represented by the arcs and the number in brackets on each arc is the time taken, in days, to complete the corresponding activity.

(a) Add the missing activities and necessary dummies to Diagram 1 in the answer book. (3)
(b) Complete Diagram 1 in the answer book to show the early event times and the late event times. (3)
Diagram 1: the network of Figure 2 with an empty box at each event for the early event time (top) and late event time (bottom)
Diagram 1
(c) State the critical activities. (1)

At the beginning of the project it is decided that activity G is no longer required.

(d) Explain what effect, if any, this will have on
(i) the shortest completion time of the project if activity G is no longer required,
(ii) the timing of the remaining activities. (3)

D1 June 2019 Q7

EdexcelOld spec14 marksCritical Path Analysis

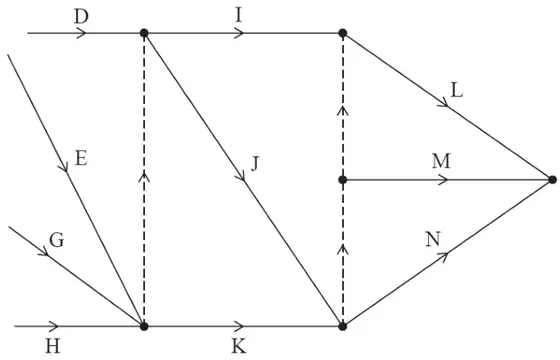

7.

Figure 5: activity network for activities A to M with early and late event times at each node
Figure 5

The network in Figure 5 shows the activities that need to be undertaken in order to complete a project. Each activity is represented by an arc. The number in brackets is the duration of the activity in hours. The early event times and late event times are shown at each node. The project can be completed in 23 hours.

Given that the total float on activity G is 1 hour,

(a) find the values of \(w\), \(x\), \(y\) and \(z\). (4)
(b) Explain the purpose of the dummy activity that has a late event time of 16 (1)
(c) List the critical activities. (1)

This project is being completed by a company that has only two permanent workers available. The project must be completed in 23 hours and, in order to achieve this, the company is prepared to hire additional workers at a cost of £35 per hour payable only for the time that the workers are engaged in activities. The company wishes to minimise the money spent on additional workers. Any worker can undertake any activity and each activity requires only one worker. Once an activity has been started it must be completed without interruption and by the same worker.

(d) Explain why the company cannot complete the project in 23 hours using only their permanent workers. (1)
(e) Schedule the activities to workers on Grid 1 in the answer book so that the project is completed in 23 hours using the minimum number of workers and at minimum cost to the company. (3)
(f) Calculate the minimum extra cost to the company. You must make your working clear. (2)

Due to bad weather, activity H may take 7 hours to complete.

(g) Explain what affect this would have on the minimum time taken to complete the whole project. (You do not need to reschedule the project.) (2)

D1 June 2019 Q5

EdexcelOld spec7 marksCritical Path Analysis

5.

ActivityImmediately preceding activities
A–
B–
CA
DA
EA, B
FC, D
GD
HD, E
IF, G
JF, G, H
(a) Draw the activity network described in the precedence table above, using activity on arc and exactly 4 dummies. (5)
(b) Explain why one of the activities I or J must be critical. (1)

It is given that activity C is a critical activity.

(c) State the activities that are therefore guaranteed to be critical. (1)

D1 June 2018 Q6

EdexcelOld spec11 marksCritical Path Analysis

6.

Figure 4: activity network with activities A to N and dummies
Figure 4

A project is modelled by the activity network shown in Figure 4. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the corresponding activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete Diagram 1 in the answer book to show the early event times and the late event times. (4)
(b) State the critical activities. (1)
(c) Draw a cascade (Gantt) chart for this project on the grid in the answer book. (4)
(d) Use your cascade chart to determine the minimum number of workers needed to complete the project in the shortest possible time. You must make specific reference to times and activities. (You do not need to provide a schedule of the activities.) (2)

D1 June 2018 Q3

EdexcelOld spec7 marksCritical Path Analysis

3.

(a) Draw the activity network described in the precedence table below, using activity on arc and exactly four dummies. (5)
ActivityImmediately preceding activities
A–
B–
C–
DA
ED
FA, B
GA, B, C
HA, B, C
IE, F, G
JE, F, G
KE, F, G, H

Given that D is a critical activity,

(b) state which other activities must also be critical. (2)

D1 June 2017 Q6

EdexcelOld spec11 marksCritical Path Analysis

6.

Figure 6: activity network with activities A to N and dummies
Figure 6

A project is modelled by the activity network shown in Figure 6. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the corresponding activity. Each activity requires exactly one worker. The project is to be completed in the shortest possible time.

(a) Complete Diagram 1 in the answer book to show the early event times and the late event times. (4)
(b) Draw a Gantt chart for the project on the grid provided in the answer book. (4)
(c) State the activities that must be happening at time 18.5 (1)

An additional activity, P, is now included in the activity network shown in Figure 6. Activity P is immediately preceded only by activity D. No activity is dependent on the completion of activity P.

Each activity still requires exactly one worker and the revised project is to be completed in the shortest possible time.

(d) Explain, briefly, whether or not the revised project can be completed in the same time as the original project if the duration of activity P is
(i) 10 days
(ii) 17 days (2)

D1 June 2016 Q7

EdexcelOld spec12 marksCritical Path Analysis

7.

Figure 6: activity network with early and late event times, including unknowns w, x, y and z
Figure 6

The network in Figure 6 shows the activities that need to be undertaken by a company to complete a project. Each activity is represented by an arc and the duration, in days, is shown in brackets. Each activity requires exactly one worker. The early event times and late event times are shown at each vertex.

Given that the total float on activity D is 1 day,

(a) find the values of \(w\), \(x\), \(y\) and \(z\). (3)
(b) On Diagram 1 in the answer book, draw a cascade (Gantt) chart for the project. (4)
(c) Use your cascade chart to determine a lower bound for the minimum number of workers needed to complete the project in the shortest possible time. You must make specific reference to times and activities. (2)

It is decided that the company may use up to 36 days to complete the project.

(d) On Diagram 2 in the answer book, construct a scheduling diagram to show how the project can be completed within 36 days using as few workers as possible. (3)

D1 June 2016 Q2

EdexcelOld spec5 marksCritical Path Analysis

2. Draw the activity network described in the precedence table below, using activity on arc and exactly three dummies. (5)

ActivityImmediately preceding activities
A–
B–
CA
DA
EB
FB
GA, E, F
HF
IC
JD, G
KD, G

D1 June 2015 Q7

EdexcelOld spec13 marksCritical Path Analysis

7.

ActivityTime taken (days)Immediately preceding activities
A5-
B7-
C8-
D5A
E7A
F10B, C
G4B, C
H9C
I8G, H
J12G, H
K7D
L10E, F, I, J

The table shows the activities required for the completion of a building project. For each activity the table shows the time taken, in days, and the immediately preceding activities. Each activity requires one worker. The project is to be completed in the shortest possible time.

Figure 6: partially completed activity network with activities A, B, C, D, G, H, J, K, L and a dummy
Figure 6

Figure 6 shows a partially completed activity network used to model the project. The activities are represented by the arcs and the numbers in brackets on the arcs are the times taken, in days, to complete each activity.

(a) Add activities, E, F and I, and exactly one dummy to Diagram 1 in the answer book. (3)
(b) Complete Diagram 1 in the answer book to show the early event times and late event times. (4)
(c) Calculate a lower bound for the number of workers needed to complete the project in the shortest possible time. You must show your working. (2)
(d) Schedule the activities, using the minimum number of workers, so that the project is completed in the minimum time. (4)

D1 June 2014 (R) Q7

EdexcelOld spec11 marksCritical Path Analysis

7.

Figure 5: activity network with activities A to K and two dummies
Figure 5

A project is modelled by the activity network shown in Figure 5. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete Diagram 1 in the answer book to show the early event times and late event times. (4)
(b) Calculate the total float for activity D. You must make the numbers you use in your calculation clear. (2)
(c) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)

The project is to be completed in the minimum time using as few workers as possible.

(d) Schedule the activities using Grid 1 in the answer book. (3)

D1 June 2014 (R) Q6

EdexcelOld spec7 marksCritical Path Analysis

6.

(i) Draw the activity network described in the precedence table below, using activity on arc and the minimum number of dummies.
ActivityImmediately preceding activities
A–
B–
C–
DA, C
EB
FE
GA
HD, F
ID, F
JH, I
(ii) Explain why each of your dummies is necessary.

D1 June 2014 Q7

EdexcelOld spec14 marksCritical Path Analysis

7.

(a) In the context of critical path analysis, define the term ‘total float’. (2)
Figure 3: activity network with events 1 to 9 and activities A to M
Figure 3

Figure 3 is the activity network for a building project. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires exactly one worker. The project is to be completed in the shortest possible time.

(b) Complete Diagram 1 in the answer book to show the early event times and the late event times. (3)
(c) State the critical activities. (1)
(d) Calculate the maximum number of days by which activity G could be delayed without affecting the shortest possible completion time of the project. You must make the numbers used in your calculation clear. (2)
(e) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)

The project is to be completed in the minimum time using as few workers as possible.

(f) Schedule the activities using Grid 1 in the answer book. (4)

D1 June 2014 Q2

EdexcelOld spec7 marksCritical Path Analysis

2.

(a) Draw the activity network described in the precedence table below, using activity on arc and exactly two dummies. (5)
ActivityImmediately preceding activities
A–
B–
C–
DA, B
EC
FA, B
GA, B
HE, F
ID
JD, G
KH
(b) Explain why each of the two dummies is necessary. (2)

D1 June 2013 (R) Q6

EdexcelOld spec7 marksCritical Path Analysis

6.

ActivityImmediately preceding activities
A–
B–
CA
DA
EB
FC D
GD
HF G
IH
JH
KI J
(a) Draw the activity network described in the precedence table, using activity on arc and exactly two dummies. (5)
(b) Explain why each of the two dummies is necessary. (2)

D1 June 2013 (R) Q3

EdexcelOld spec12 marksCritical Path Analysis

3.

Figure 3: activity network with activities A to M
Figure 3

A project is modelled by the activity network shown in Figure 3. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete Diagram 1 in the answer book to show the early event times and late event times. (4)
(b) Calculate the total float for activity H. You must make the numbers you use in your calculation clear. (2)
(c) Calculate a lower bound for the number of workers needed to complete the project in the shortest possible time. Show your calculation. (2)

Diagram 2 in the answer book shows a partly completed scheduling diagram for this project.

(d) Complete the scheduling diagram, using the minimum number of workers, so that the project is completed in the minimum time. (4)

D1 June 2013 Q7

EdexcelOld spec17 marksCritical Path Analysis

7.

Figure 5: activity network with events 1 to 12 and activities A to S
Figure 5

[The sum of the duration of all activities is 172 days]

A project is modelled by the activity network shown in Figure 5. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete Diagram 1 in the answer book to show the early event times and late event times. (4)
(b) Calculate the total float for activity M. You must make the numbers you use in your calculation clear. (2)
(c) For each of the situations below, explain the effect that the delay would have on the project completion date.
(i) A 2 day delay on the early start of activity P.
(ii) A 2 day delay on the early start of activity Q. (2)
(d) Calculate a lower bound for the number of workers needed to complete the project in the shortest possible time. (1)

Diagram 2 in the answer book shows a partly completed cascade chart for this project.

(e) Complete the cascade chart. (4)
(f) Use your cascade chart to determine a second lower bound on the number of workers needed to complete the project in the shortest possible time. You must make specific reference to times and activities. (2)
(g) State which of the two lower bounds found in (d) and (f) is better. Give a reason for your answer. (2)

D1 January 2013 Q7

EdexcelOld spec16 marksCritical Path Analysis

7.

Figure 7: activity network with events 1 to 9 and activities A to M
Figure 7

Figure 7 is the activity network relating to a building project. The activities are represented by the arcs. The number in brackets on each arc gives the time to complete the activity. Each activity requires one worker.

The project must be completed in the shortest possible time.

(a) Explain the reason for the dotted line from event 4 to event 6 as shown in Figure 7. (2)
(b) Complete Diagram 1 in the answer book to show the early event times and the late event times. (4)
(c) State the critical activities. (1)
(d) Calculate the total float for activity G. You must make the numbers you use in your calculation clear. (2)
(e) Draw a Gantt chart for this project on the grid provided in the answer book. (4)
(f) State the activities that must be happening at time 5.5 (1)
(g) Use your Gantt chart to determine the minimum number of workers needed to complete the project in the minimum time. You must justify your answer. (2)

D1 June 2012 Q6

EdexcelOld spec14 marksCritical Path Analysis

6.

Figure 5: activity network with events 1 to 8 and activities A to K
Figure 5

Figure 5 is the activity network relating to a development project. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete the precedence table in the answer book. (2)
(b) Complete Diagram 1 in the answer book to show the early event times and late event times. (4)
(c) Calculate the total float for activity E. You must make the numbers you use in your calculation clear. (2)
(d) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)
(e) Schedule the activities using the minimum number of workers so that the project is completed in the minimum time. (4)

D1 January 2012 Q7

EdexcelOld spec16 marksCritical Path Analysis

7.

Figure 7: activity network on events 1 to 8: A (6) 1–2, B (5) 1–4, C (7) 1–3, D (5) 2–6, E (6) 2–4, F (8) 3–4, G (4) 3–7, H (5) 3–5, dummy 4–6, dummy 5–7, I (6) 4–8, K (3) 6–8, J (4) 7–8
Figure 7

A project is modelled by the activity network shown in Figure 7. The activities are represented by the arcs. The number in brackets on each arc gives the time required, in hours, to complete the activity. The numbers in circles are the event numbers. Each activity requires one worker.

(a) Explain the significance of the dummy activity
(i) from event 4 to event 6,
(ii) from event 5 to event 7
(3)
(b) Calculate the early time and the late time for each event. Write these in the boxes in the answer book. (4)
(c) Calculate the total float on each of activities D and G. You must make the numbers you use in your calculations clear. (3)
(d) Calculate a lower bound for the minimum number of workers required to complete the project in the minimum time. (2)
(e) On the grid in your answer book, draw a cascade (Gantt) chart for this project. (4)

D1 June 2011 Q7

EdexcelOld spec16 marksCritical Path Analysis

7.

Figure 7: activity network on events 1 to 8: A (4) 1–2, B (7) 1–3, dummy 3–2, E (2) 2–5, C (4) 2–4, D (5) 3–4, F (5) 3–6, G (4) 3–7, dummy 4–5, H (4) 4–6, I (3) 5–6, J (10) 5–8, K (5) 6–8, dummy 6–7, L (6) 7–8
Figure 7

A project is modelled by the activity network shown in Figure 7. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete the precedence table in the answer book. (3)
(b) Complete Diagram 1 in the answer book, to show the early event times and late event times. (4)
(c) State the critical activities. (2)
(d) On the grid in your answer book, draw a cascade (Gantt) chart for this project. (4)
(e) By considering the activities that must take place between time 7 and time 16, explain why it is not possible to complete this project with just 3 workers in the minimum time. (3)

D1 January 2011 Q7

EdexcelOld spec16 marksCritical Path Analysis

7.

Figure 7: activity network on events 1 to 9: A (4) 1–2, B (6) 1–3, C (3) 2–3, D (7) 2–5, E (4) 2–4, F (3) 3–4, G (5) 3–6, H (2) 4–6, dummy 4–5, I (3) 5–7, dummy 6–7, J (9) 6–9, K (5) 7–8, L (3) 7–9, dummy 8–9
Figure 7

The network in Figure 7 shows the activities that need to be undertaken to complete a maintenance project. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. The numbers in circles are the events.

Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete the precedence table for this network in the answer book. (3)
(b) Explain why each of the following is necessary.
(i) The dummy from event 6 to event 7.
(ii) The dummy from event 8 to event 9.
(3)
(c) Complete Diagram 2 in the answer book to show the early and the late event times. (4)
(d) State the critical activities. (2)
(e) Calculate the total float on activity K. You must make the numbers used in your calculation clear. (2)
(f) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. (2)

D1 June 2010 Q8

EdexcelOld spec11 marksCritical Path Analysis

8.

Figure 7: activity network with activities A (4), B (2), C (3), D (5), E (6), F (9), G (10), H (2), I (4), J (5), K (3), L (6) and four dummies
Figure 7

A project is modelled by the activity network shown in Figure 7. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete Diagram 2 in the answer book to show the early and late event times. (4)
(b) State the critical activities. (1)
(c) On Grid 1 in the answer book, draw a cascade (Gantt) chart for this project. (4)
(d) Use your cascade chart to determine a lower bound for the number of workers needed.
You must justify your answer. (2)

D1 January 2010 Q6

EdexcelOld spec15 marksCritical Path Analysis

6.

Figure 5: activity network. A(3) 1 to 2; B(5) 1 to 3; dummy 2 to 3; C(4) 2 to 4; D(2) 2 to 5; E(3) 3 to 5; dummy 4 to 5; F(5) 4 to 6; G(6) 5 to 6; H(2) 6 to 7
Figure 5

Figure 5 is the activity network relating to a building project.  The number in brackets on each arc gives the time taken, in days, to complete the activity.

(a) Explain the significance of the dotted line from event 2 to event 3. (2)
(b) Complete the precedence table in the answer booklet. (3)
(c) Calculate the early time and the late time for each event, showing them on the diagram in the answer booklet. (4)
(d) Determine the critical activities and the length of the critical path. (2)
(e) On the grid in the answer booklet, draw a cascade (Gantt) chart for the project. (4)

D1 June 2009 Q8

EdexcelOld spec15 marksCritical Path Analysis

8.

Figure 5: activity network with activities A to M and durations in days
Figure 5

A construction project is modelled by the activity network shown in Figure 5. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

(a) Complete Diagram 2 in the answer book, showing the early and late event times. (4)
(b) State the critical activities. (1)
(c) Find the total float for activities M and H. You must make the numbers you use in your calculations clear. (3)
(d) On the grid provided, draw a cascade (Gantt) chart for this project. (4)

An inspector visits the project at 1pm on days 16 and 31 to check the progress of the work.

(e) Given that the project is on schedule, which activities must be happening on each of these days? (3)

D1 January 2009 Q8

EdexcelOld spec16 marksCritical Path Analysis

8.

Figure 5: activity network with events 1 to 10 and activities A to N with durations in days
Figure 5

The network in Figure 5 shows the activities involved in a process. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, taken to complete the activity.

(a) Calculate the early time and the late time for each event, showing them on the diagram in the answer book. (4)
(b) Determine the critical activities and the length of the critical path. (3)
(c) Calculate the total float on activities F and G. You must make the numbers you used in your calculation clear. (3)
(d) On the grid in the answer book, draw a cascade (Gantt) chart for the process. (4)

Given that each task requires just one worker,

(e) use your cascade chart to determine the minimum number of workers required to complete the process in the minimum time. Explain your reasoning clearly. (2)

D1 January 2009 Q3

EdexcelOld spec7 marksCritical Path Analysis

3.

(a) Draw the activity network described in this precedence table, using activity on arc and exactly two dummies. (5)
ActivityImmediately preceding activities
A-
B-
C-
DB
EB,  C
FB, C
GF
HF
IG, H
JI
(b) Explain why each of the two dummies is necessary. (2)

D1 June 2008 Q7

EdexcelOld spec14 marksCritical Path Analysis

7.

Figure 6: activity network with activities A to Q, durations in days, and early and late event times including v, w, x, y and z
Figure 6

The network in Figure 6 shows the activities that need to be undertaken to complete a building project. Each activity is represented by an arc. The number in brackets is the duration of the activity in days. The early and late event times are shown at each vertex.

(a) Find the values of \(v\), \(w\), \(x\), \(y\) and \(z\). (3)
(b) List the critical activities. (1)
(c) Calculate the total float on each of activities H and J. (2)
(d) Draw a cascade (Gantt) chart for the project. (4)

The engineer in charge of the project visits the site at midday on day 8 and sees that activity E has not yet been started.

(e) Determine if the project can still be completed on time. You must explain your answer. (2)

Given that each activity requires one worker and that the project must be completed in 35 days,

(f) use your cascade chart to determine a lower bound for the number of workers needed. You must justify your answer. (2)

D1 January 2008 Q5

EdexcelOld spec7 marksCritical Path Analysis

5.

(a) Draw the activity network described in this precedence table, using activity on arc and exactly two dummies. (4)
ActivityImmediately preceding activities
\(A\)-
\(B\)-
\(C\)\(A\)
\(D\)\(B\)
\(E\)\(B\), \(C\)
\(F\)\(B\), \(C\)
(b) Explain why each of the two dummies is necessary. (3)

D1 January 2008 Q4

EdexcelOld spec11 marksCritical Path Analysis

4.

Figure 5: activity network with activities A to M, durations in hours, and some early and late event times
Figure 5

A project is modelled by the activity network shown in Figure 5. The activities are represented by the arcs. The number in brackets on each arc gives the time, in hours, to complete the activity. Some of the early and late times for each event are shown.

(a) Calculate the missing early and late times and hence complete Diagram 1 in your answer book. (4)
(b) Calculate the total float on activities D, G and I. You must make your calculations clear. (4)
(c) List the critical activities. (1)

Each activity requires one worker.

(d) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. (2)

D1 June 2007 Q6

EdexcelOld spec15 marksCritical Path Analysis

6.

Figure 5: activity network with activities A to L, durations in brackets, and early and late event time boxes
Figure 5

The network in Figure 5 shows the activities that need to be undertaken to complete a project. Each activity is represented by an arc. The number in brackets is the duration of the activity in days. The early and late event times are to be shown at each vertex and some have been completed for you.

(a) Calculate the missing early and late times and hence complete Diagram 2 in your answer book. (3)
(b) List the two critical paths for this network. (2)
(c) Explain what is meant by a critical path. (2)

The sum of all the activity times is 110 days and each activity requires just one worker.

The project must be completed in the minimum time.

(d) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)
(e) List the activities that must be happening on day 20. (2)
(f) Comment on your answer to part (e) with regard to the lower bound you found in part (d). (1)
(g) Schedule the activities, using the minimum number of workers, so that the project is completed in 30 days. (3)

D1 January 2007 Q6

EdexcelOld spec16 marksCritical Path Analysis

6.

Figure 5: activity network with events 1 to 10 and activities A(8) to M(7); dummies from 4 to 7 and from 6 to 8
Figure 5

A project is modelled by the activity network shown in Figure 5. The activities are represented by the arcs. The number in brackets on each arc gives the time, in hours, to complete the activity. The numbers in circles are the event numbers. Each activity requires one worker.

(a) Explain the purpose of the dotted line from event 6 to event 8. (1)
(b) Calculate the early time and late time for each event. Write these in the boxes in the answer book. (4)
(c) Calculate the total float on activities \(D\), \(E\) and \(F\). (3)
(d) Determine the critical activities. (2)
(e) Given that the sum of all the times of the activities is 95 hours, calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)
(f) Given that workers may not share an activity, schedule the activities so that the process is completed in the shortest time using the minimum number of workers. (4)

D1 June 2006 Q5

EdexcelOld spec15 marksCritical Path Analysis

5.

Figure 4: activity network with events 1 to 9 and activities A(10) to N(12)
Figure 4

An engineering project is modelled by the activity network shown in Figure 4. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest time.

(a) Calculate the early time and late time for each event. Write these in boxes in Diagram 1 in the answer book. (4)
(b) State the critical activities. (1)
(c) Find the total float on activities \(D\) and \(F\). You must show your working. (3)
(d) On the grid in the answer book, draw a cascade (Gantt) chart for this project. (4)

The chief engineer visits the project on day 15 and day 25 to check the progress of the work.

Given that the project is on schedule,

(e) which activities must be happening on each of these two days? (3)

D1 January 2006 Q5

EdexcelOld spec15 marksCritical Path Analysis

5.

Figure 5: activity network with activities A(4) to N(4)
Figure 5

The network in Figure 5 shows the activities involved in a process. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, taken to complete the activity.

(a) Calculate the early time and late time for each event, showing them on the diagram in the answer book. (4)
(b) Determine the critical activities and the length of the critical path. (2)
(c) On the grid in the answer book, draw a cascade (Gantt) chart for the process. (4)

Each activity requires only one worker, and workers may not share an activity.

(d) Use your cascade chart to determine the minimum numbers of workers required to complete the process in the minimum time. Explain your reasoning clearly. (2)
(e) Schedule the activities, using the number of workers you found in part (d), so that the process is completed in the shortest time. (3)

D1 June 2005 Q4

EdexcelOld spec7 marksCritical Path Analysis

4. The precedence table shows the activities involved in a project.

ActivityImmediately preceding activities
\(A\)–
\(B\)–
\(C\)–
\(D\)\(A\)
\(E\)\(A\)
\(F\)\(B\)
\(G\)\(B\)
\(H\)\(C, D\)
\(I\)\(E\)
\(J\)\(F, H\)
\(K\)\(G, J\)
\(L\)\(G\)
\(M\)\(L\)
\(N\)\(L\)
(a) Draw the activity network for this project, using activity on arc and using two dummies. (4)
(b) Explain why each of the two dummies is necessary. (3)

D1 January 2005 Q2

EdexcelOld spec7 marksCritical Path Analysis

2. The precedence table for activities involved in producing a computer game is shown below.

ActivityMust be preceded by
\(A\)–
\(B\)–
\(C\)\(B\)
\(D\)\(A, C\)
\(E\)\(A\)
\(F\)\(E\)
\(G\)\(E\)
\(H\)\(G\)
\(I\)\(D, F\)
\(J\)\(G, I\)
\(K\)\(G, I\)
\(L\)\(H, K\)

An activity on arc network is to be drawn to model this production process.

(a) Explain why it is necessary to use at least two dummies when drawing the activity network. (2)
(b) Draw the activity network using exactly two dummies. (5)
