D1 June 2007 Q6
6.

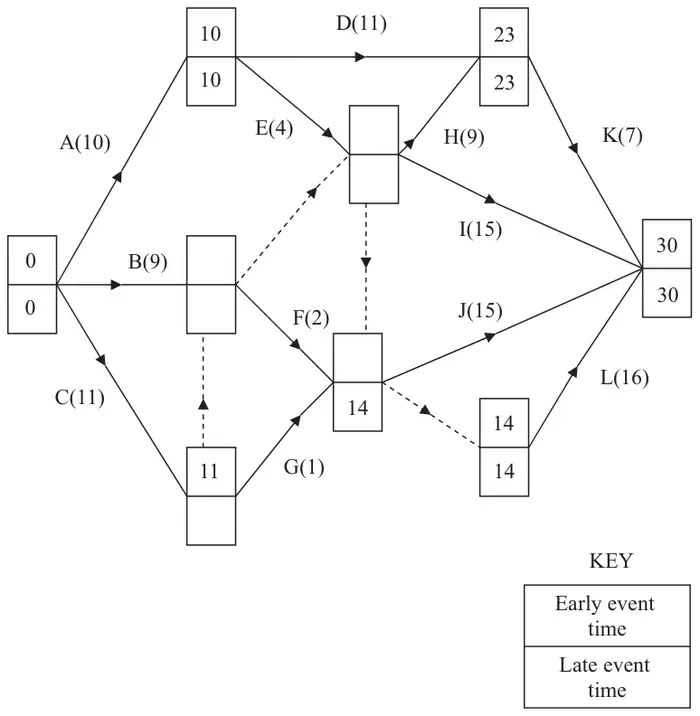

The network in Figure 5 shows the activities that need to be undertaken to complete a project. Each activity is represented by an arc. The number in brackets is the duration of the activity in days. The early and late event times are to be shown at each vertex and some have been completed for you.
(a) Calculate the missing early and late times and hence complete Diagram 2 in your answer book. (3)
(b) List the two critical paths for this network. (2)
(c) Explain what is meant by a critical path. (2)
The sum of all the activity times is 110 days and each activity requires just one worker.
The project must be completed in the minimum time.
(d) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)
(e) List the activities that must be happening on day 20. (2)
(f) Comment on your answer to part (e) with regard to the lower bound you found in part (d). (1)
(g) Schedule the activities, using the minimum number of workers, so that the project is completed in 30 days. (3)
| Scheme | Marks |
|---|---|
![]() | B3, 2, 1, 0 |
| (3) |
| Scheme | Marks |
|---|---|
| A E H K | B2, 1, 0 |
| A E L | |
| (2) |
| Scheme | Marks |
|---|---|
| Idea of ‘critical’ – zero float, no delay, immediate – if late project will finish late etc. | B1 |
| Idea of ‘path’ – from start to end event + continuous – the event forming end of one activity forms the start of the next – sequence or series or link or run … | B1 |
| (2) |
Notes
S.C. “longest path” gets 1st B1 only.
| Scheme | Marks |
|---|---|
| \(\dfrac{110}{30}\ (= 3.7/3.6)\ \therefore\) 4 workers | M1 A1 |
| (2) |
| Scheme | Marks |
|---|---|
| D, H, I, J, L | B2, 1, 0 |
| (2) |
| Scheme | Marks |
|---|---|
| It will not be possible to find a solution with 4 workers to complete the project in the minimum time. 5 workers will be needed. Accept “an extra worker is required” | B1 |
| (1) |
| Scheme | Marks |
|---|---|

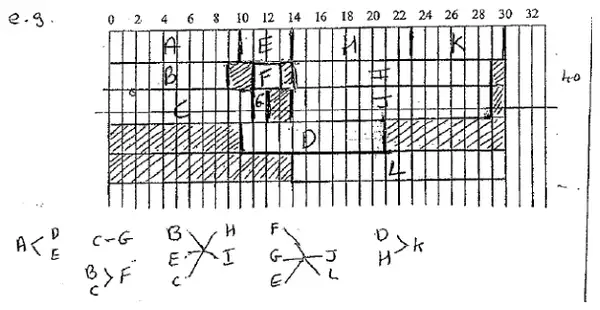

e.g.![]() | M1 A1 A1 |
| (3) | |
| (15 marks) |
