D1 January 2008 Q4
4.

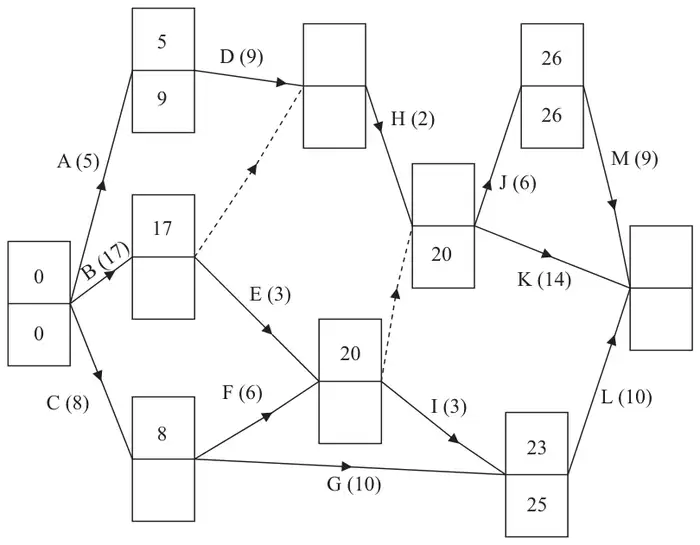

A project is modelled by the activity network shown in Figure 5. The activities are represented by the arcs. The number in brackets on each arc gives the time, in hours, to complete the activity. Some of the early and late times for each event are shown.
(a) Calculate the missing early and late times and hence complete Diagram 1 in your answer book. (4)
(b) Calculate the total float on activities D, G and I. You must make your calculations clear. (4)
(c) List the critical activities. (1)
Each activity requires one worker.
(d) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. (2)
| Scheme | Marks |
|---|---|
![]() | M1 A1 M1 A1 |
| (4) |
Notes
Q4(a) 1M1 Top 3 boxes completed, generally ascending L to R
1A1 cao
2M1 Bottom 4 boxes completed, generally descending R to L
2A1 cao
| Scheme | Marks |
|---|---|
| Total float on D = 18ft − 5 − 9 = 4ft G = 25 − 8 − 10 = 7 I = 25 − 20 − 3 = 2 | M1 A2, 1ft, 0 B1 |
| (4) |
Notes
(b) 1M1 Correct (ft) three numbers visible for at least one calculation.
1A1ft one correct value (ft on D)
1A1 2 correct values
1B1 3 correct values (even if no working seen)
| Scheme | Marks |
|---|---|
| Critical activities: B E J M | B1 |
| (1) |
Notes
(c) 1B1 cao
| Scheme | Marks |
|---|---|
| Lower bound \(= \dfrac{102}{35} = 2.914\) | M1 |
| \(\therefore\) 3 workers | A1 |
| (2) | |
| (11 marks) |
Notes
(d) 1M1 102 ÷ 35ft
1A1 cao
