D1 June 2010 Q8

EdexcelOld spec11 marksCritical Path Analysis

8.

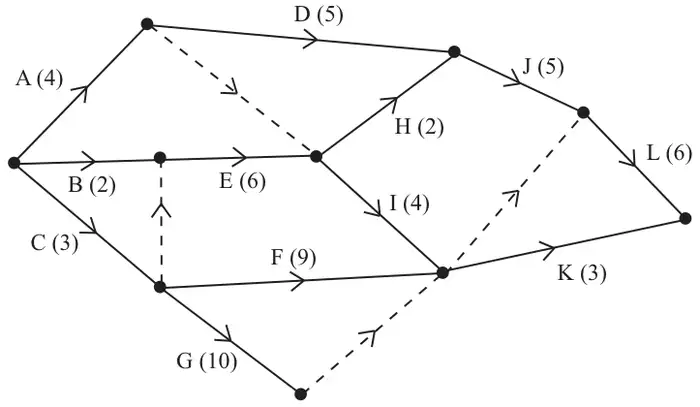

Figure 7: activity network with activities A (4), B (2), C (3), D (5), E (6), F (9), G (10), H (2), I (4), J (5), K (3), L (6) and four dummies
Figure 7

A project is modelled by the activity network shown in Figure 7. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

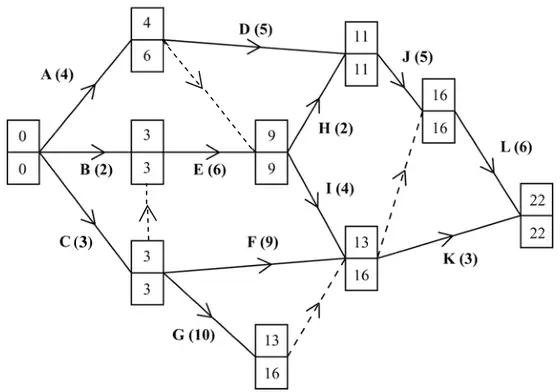

(a) Complete Diagram 2 in the answer book to show the early and late event times. (4)
(b) State the critical activities. (1)

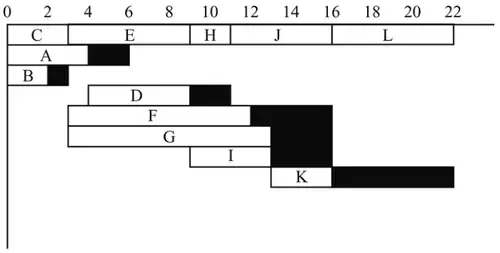

(c) On Grid 1 in the answer book, draw a cascade (Gantt) chart for this project. (4)
(d) Use your cascade chart to determine a lower bound for the number of workers needed.
You must justify your answer. (2)
