D1 June 2014 (R) Q7

EdexcelOld spec11 marksCritical Path Analysis

7.

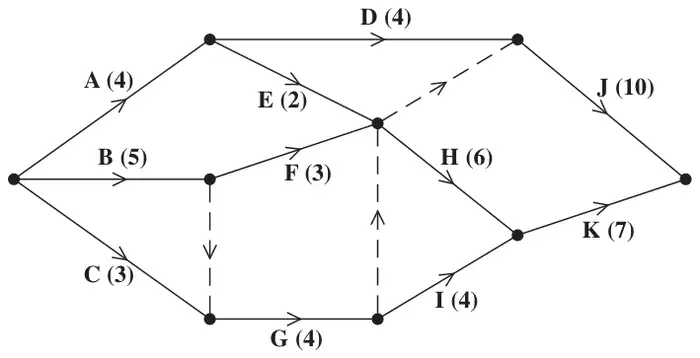

Figure 5: activity network with activities A to K and two dummies
Figure 5

A project is modelled by the activity network shown in Figure 5. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires one worker. The project is to be completed in the shortest possible time.

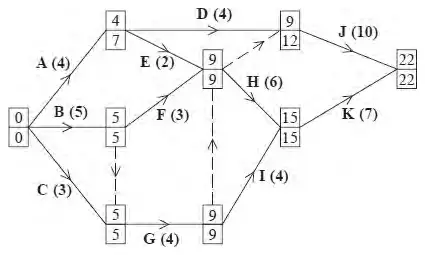

(a) Complete Diagram 1 in the answer book to show the early event times and late event times. (4)
(b) Calculate the total float for activity D. You must make the numbers you use in your calculation clear. (2)
(c) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)

The project is to be completed in the minimum time using as few workers as possible.

(d) Schedule the activities using Grid 1 in the answer book. (3)
