D1 June 2014 Q7

EdexcelOld spec14 marksCritical Path Analysis

7.

(a) In the context of critical path analysis, define the term ‘total float’. (2)
Figure 3: activity network with events 1 to 9 and activities A to M

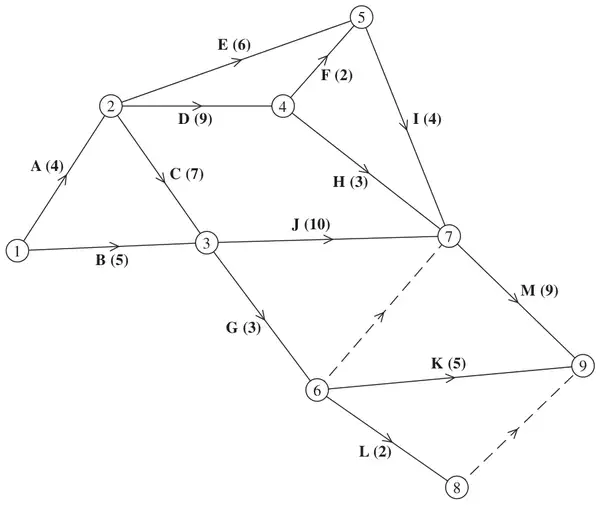

Figure 3

Figure 3 is the activity network for a building project. The activities are represented by the arcs. The number in brackets on each arc gives the time, in days, to complete the activity. Each activity requires exactly one worker. The project is to be completed in the shortest possible time.

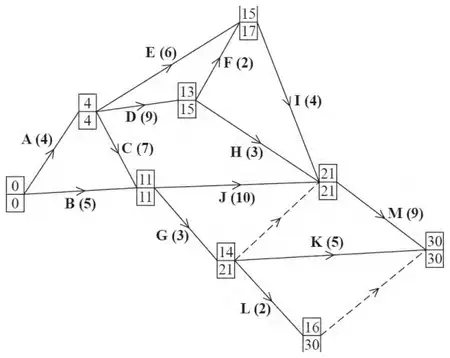

(b) Complete Diagram 1 in the answer book to show the early event times and the late event times. (3)
(c) State the critical activities. (1)
(d) Calculate the maximum number of days by which activity G could be delayed without affecting the shortest possible completion time of the project. You must make the numbers used in your calculation clear. (2)
(e) Calculate a lower bound for the number of workers needed to complete the project in the minimum time. You must show your working. (2)

The project is to be completed in the minimum time using as few workers as possible.

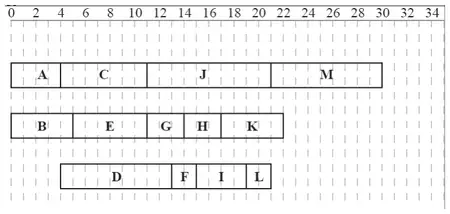

(f) Schedule the activities using Grid 1 in the answer book. (4)
